Don Irrigation Scheme
Tranche Three - Phase One

The Business Case for the Don Irrigation Scheme has been approved. The preferred option is for a 4,750ML irrigation scheme in the NW of Tasmania covering an area from West Kentish north through to Don Heads. Commencement of construction is scheduled for the first half of 2021 with scheme water available for irrigators for the 2022/23 irrigation season. Water sales have been completed and TI are completing the design optimisation and approvals stage prior to going to tender. This includes Local Government approval from municipalities, Irrigation District Application, Flora and Fauna Permits, Aboriginal and Historical Heritage Permits, EPBC referral and Easement applications (pipelines excluded). If anyone is considering further water purchases please contact Jacob Tierney on 0400068869 before the last week of April.

The Don Irrigation Scheme (DON) is planned to deliver 4,750ML pa of high reliability irrigation water into the Don, Forth, Barrington and Sheffield districts.

Originally proposed to be a smaller 3,000ML scheme providing water to the Don and Forth area, Tasmanian Irrigation (TI) extended the scheme area further south following a successful EOI process that was requested by local Farmers from the Sheffield and West Kentish region. The scheme once constructed will provide water to some of the best land in the State. The area is famous for its cropping and further to the south for its dairy enterprises.

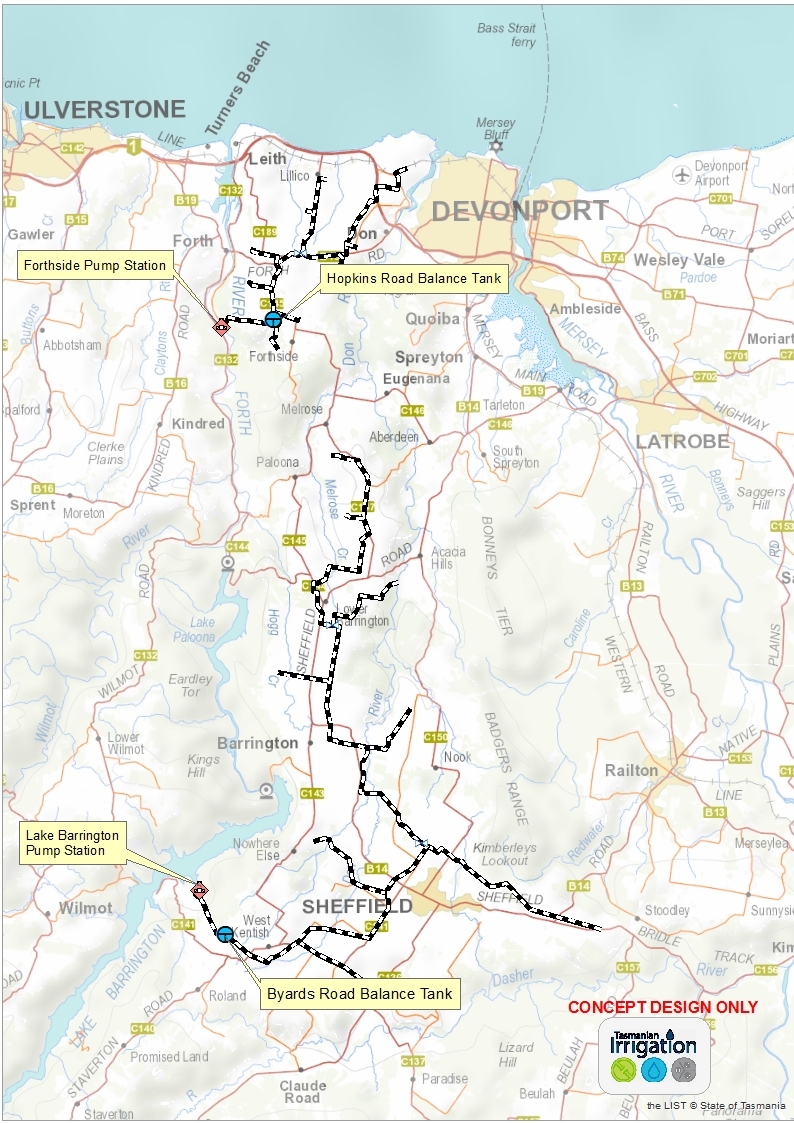

The project is in the approvals phase after the preferred option was launched at the Lower Barrington Town Hall on 10 March 2020. The Forth River catchment provides the 95% reliability TI schemes are required to achieve and is regarded as the best water source in the area. Scheme design includes a pump station on Lake Barrington and a second pump station downstream of Paloona Dam at Forthside. No storage dams are planned and the pump stations will pump to balance tanks with distribution to the irrigators via 60km of distribution pipeline. A 180-day summer irrigation season is proposed, winter delivery could also be available given adequate demand from the irrigators. The peak flow rate for the scheme is 41.7ML/day.

TI are currently finalising the approvals phase, including tendering for construction.

53

KMs of Pipeline

0

Dams

3

Pump Stations

0

Power Stations

Milestones / Forecasts
Funding confirmed Yes
Community meeting April 2019
EOIs launched April 2019
EOIs concluded May 2019
IRC appointed April 2019
Preferred option launched March 2020
Water sales launched April 2020
Business case submitted October 2020
Construction start date December 2021
Construction end date Mid 2023
Water delivery commencement 2023
First full season 2023/24
Fast facts
Initial ML capacity 3,000 ML
Total EOIs received 4,500 ML
Final scheme capacity 4,750 ML
Total forecast cost To be confirmed
Number of irrigators 64
Forecast season opening October
Forecast season closing March
Daily flow rate 39.58 ML / day
Water entitlement price $1,425 / ML
